Aetna RealtyPiedmont Triad Industrial Center (PTIC)Prepared by GMGDecide what to spend, when to spend it, and why.
This model allows ownership to test multiple roof strategies over time. Each roof can be maintained, repaired, restored, retrofitted, replaced, or deferred. The dashboard shows how those selections affect capital timing, risk, remaining useful life, and future cost exposure. The purpose is not to force one recommendation, but to show the financial consequences of each path.
The big idea
What happens if I spend a little now, wait, and spend later?
The model is built to answer that asset-management question, not just “what does this roof cost today?” It separates a one-time estimate from a time-based capital plan by showing how smaller near-term actions, deferred choices, and later replacement paths change cost exposure and remaining useful life.

Prepared by GMG

Roof assets
9
7 active decisions
Total SF managed
1,046,499
757,684 active SF
Financial exposure
$8.73M
Spend + deferred liability
High-risk active SF
348,440
Risk area requiring timing clarity
Dashboard legend
Use the color rating to read condition risk, capital timing, and deferred exposure at a glance. Roof rows also expose a report link on hover or focus.
Immediate timing clarity; failure impact or condition is driving capital exposure.
Restoration/repair window should be protected before deferral changes the economics.
Monitor, maintain, and preserve warranty/condition value.
Annual monitor cost that maintains the roof; not the same as one-time capital.
Three-year cost of waiting, including condition drag, emergency premium, and lost option value.
Owner-selected one-time spend sequenced into the capital forecast.
Completed capital asset; excluded from active wet-insulation prioritization.
No current moisture signal in the available scan evidence.
Limited wet-area signal; preserve restoration economics with planned maintenance.
Moisture evidence is material enough to influence timing and decay assumptions.
Moisture and condition can accelerate deterioration and narrow capital options.
Owner relationship context
Aetna Realty / Piedmont Triad Industrial Center (PTIC)
The model treats IR moisture as a decay-rate signal, not a sales trigger. Moisture evidence changes the timing value of capital, while ownership priorities decide whether to repair, restore, retrofit, replace, or defer.
Stabilized SF
288,815
Active decision SF
757,684
Capital deployed
$3.67M
Next owner conversation
Review active-decision roofs by capital efficiency: confirm Roof 4 scope first, preserve restoration windows on Roofs 5, 7, and 9, and validate Roof 8 before committing replacement-level capital.
Once PTIC is accepted as the operating model, the same CRM-style capital ledger can be expanded across additional Aetna Realty commercial assets to show portfolio-wide exposure, spend timing, warranty assets, and deferred liabilities.
Owner visual orientation
Selectable PTIC roof map and direct report launcher

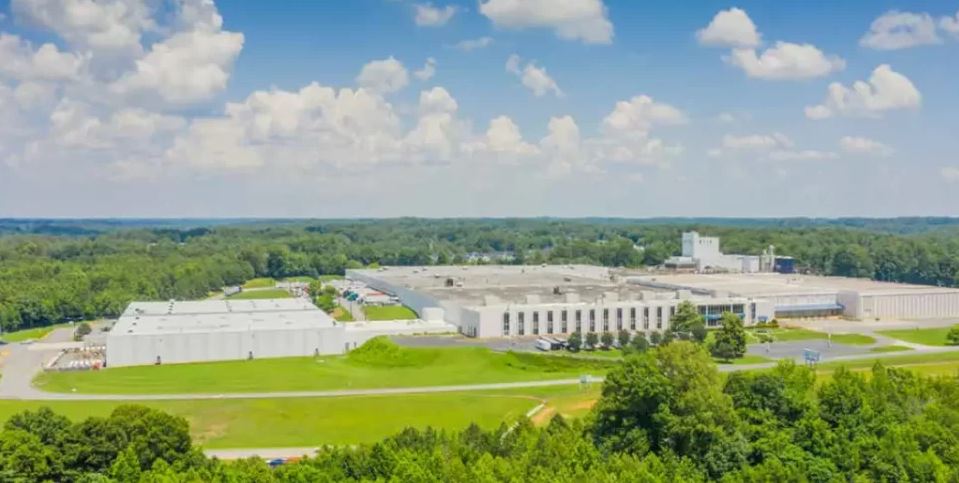

The map now sits near the top of the command center so owners can start from a physical roof section instead of hunting through the register. The overlay uses the uploaded PTIC overview image with approximate roof-zone positions until source plans are supplied.

Approximate overlay
Roof zones are positioned over the uploaded PTIC overview image as working placeholders. The Building 200 drawing gives Roof 1 a source-accurate plan reference; the Section 4 plot gives Roof 4 plan/detail and scope context while excluding the incorrect top-left photo; the 6-4-2025 leak catalog adds Roof 4 accelerated-decay evidence from failed patchwork, trapped moisture, open laps, missing flashings, and submerged tie-ins; and the Roof 6 plot adds completed, deduct-scope, and wet/deck-remediation source context. Additional roof plans, a site plan, satellite markup, or NIRA overview can make the rest of these polygons survey-accurate.
Building floor plan reference

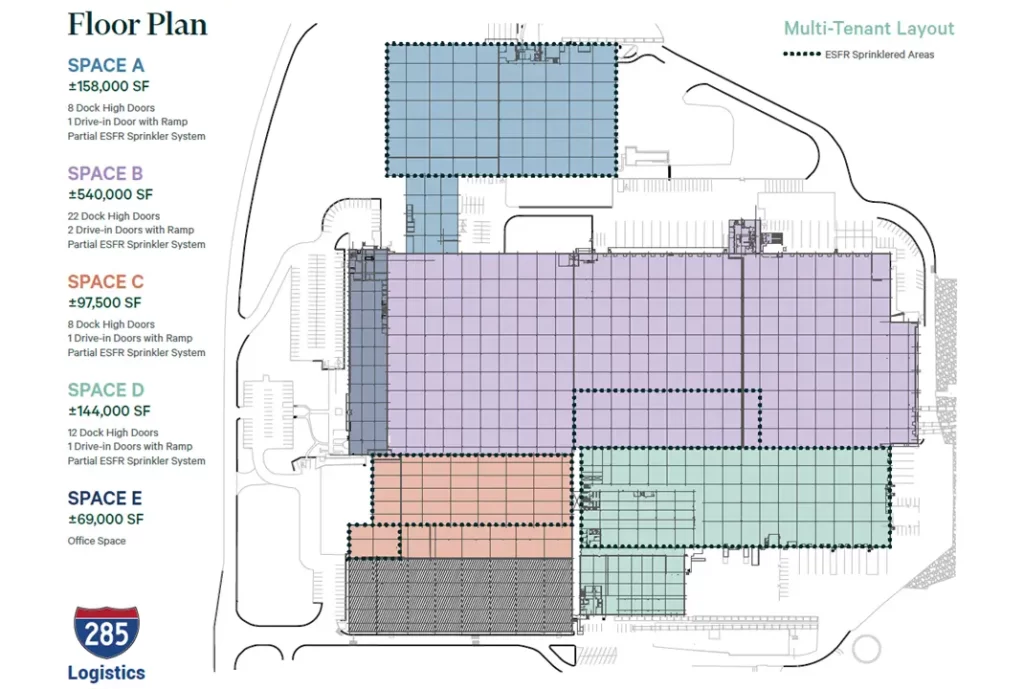

Aetna Realty / I-285 Logistics layout context

This uploaded Aetna Realty / I-285 Logistics floor plan is treated as a building-specific reference, not decoration. It helps connect roof-section decisions to tenant demising, circulation, and interior layout context before capital, expense, or deferral scenarios are finalized.
Selected roof context
Roof 4: EcoLab Main
EcoLab primary operations; high rentability sensitivity
Status
At risk
SF
174,400
Annual maintain
$4K
3-year deferral
$1.48M
Report launcher
Roof 1
Upper Walker / Bldg 200
Under warranty · $0 defer
Roof 2
Lower Walker
Maintainable · $25 defer
Roof 3
Duro-Last Section
At risk · $317K defer
Roof 4
EcoLab Main
At risk · $1.48M defer
Roof 5
EcoLab 2
Maintainable · $416K defer
Roof 6
Nalco / Roof Area 6
Under warranty · $0 defer
Roof 7
Nalco / Roof Area 7
Maintainable · $275K defer
Roof 8
Ballast EPDM & TPO
At risk · $42K defer
Roof 9
Wake Forest / BUR
Maintainable · $184K defer
Executive financials
Expense, capital, and exposure forecast
The financial view separates near-term selected spend from deferred liability so a lower first-year budget does not hide future asset exposure.
Capital deployed
$3.67M
Completed / stabilized assets
Selected 5-year spend
$5.96M
Escalated selected actions
Deferred liability
$0
Cost of delaying selected work
$12/SF annual target
$3.92M
1,046,499 SF ÷ roof lives
Predictability benchmark
Straight-line roof value consumption
If a functional roof is valued at $12/SF, the managed portfolio carries $12.6M of modeled roof utility. Dividing total portfolio value by the SF-weighted average remaining life produces an annual target spend of $1.34M. That number is not a tax deduction; it is the steady funding line ownership can compare against lumpy replacement demands.
Total roof SF
1,046,499
Current model area
Weighted life
9.3 yrs
SF-weighted RSL
Annual SF use
326,624
SF consumed / year
Maintenance expense lane
$2.76M
Annual monitor, repair, and deferral-control dollars should be tracked separately from capitalized roof asset dollars so the owner can see operating drag clearly.
Capital asset lane
$12.6M
At $12/SF, the portfolio carries a modeled functional roof value that can be translated into a straight-line annual funding benchmark.
CPA review lane
Aggregate 179 limit
Section 179 is a company-level aggregate limit, not a per-roof limit. Capital roof improvements may be eligible, but phase-outs, placed-in-service totals, MACRS, and 179D require CPA review.
Owner tax posture — CPA review required
The planning target should support, not replace, tax advice. For each roof action, classify the dollars as maintenance expense, capitalized roof asset, or CPA-review item. Section 179 should be reviewed as an aggregate company-level limitation rather than a per-asset allowance; commercial roof improvements may qualify, but the annual limit, phase-out threshold, placed-in-service totals, taxable income limitation, MACRS depreciation, repair-versus-capital treatment, and possible Section 179D energy-efficiency treatment depend on facts and CPA review. The owner objective is optimal cash deployment: spend at the right time, preserve roof optionality, and avoid turning avoidable maintenance into a single large taxable capital event where the tax rules allow better timing.
Data-driven AI strategy
Highest-value path for owner cash
This layer does not chase the cheapest plan or the most expensive plan. It looks for the cash-value line where right-time spend protects RSL, reduces lifecycle exposure, and keeps owner cash from being trapped in roof work too early.
AI recommended path
Roof 3: Retrofit
Highest-value cash path weighs $299K of right-time spend against $626K of modeled deferral exposure, 34,288 weighted rentable SF, IR decay, and RSL protection.
Cash value score
100/100
Timing band
Spend now
Right-time spend
$1.80M
Avoided exposure
$4.46M
Spend timing vs deferral liability
Where cash spend avoids future roof drag
Blue bars show right-time spend. Copper bars show modeled deferral liability avoided. The red line keeps the liability correlation visible instead of hiding it in a separate note.
Optimal line
Too early ties up cash that could be used elsewhere. Too late turns avoidable work into liability. The recommended line is where RSL protection and avoided future cost justify the cash outlay.
Rentability layer
Each roof now has a placeholder rentability weight. When rentable SF by roof section is provided, the score can weight roofs protecting higher-value tenant space above lower-yield areas.
Owner cash principle
Cash on roofs is cash not spent elsewhere; the model only favors roof spend when timing creates meaningful cost avoidance, RSL protection, or rentability protection.
À la carte Optionality
David can choose the category, scope, and year roof by roof
Use presets as starting lanes, then override any roof individually. The owner-facing point is Optionality: compare maintenance expense, capital improvements, deferral exposure, and the year-by-year win/loss against the straight-line annual target.
Annual target line
$1.34M
$12.6M ÷ 9.3 yrs. Spend below the line is marked as a win; above the line is a loss.
Step 1 · choose roof
Step 2 · à la carte controls
Roof 4: EcoLab Main
Window
Lost
Cash score
100/100
Escalated spend
$1.37M
Deferred liability
$0
Annual expense
$4K
2026 target result
LOSS
Owner interpretation
Roof 4 is set to Capital / Retrofit for 100% of the roof in 2026. The year shows LOSS because modeled cash deployment is $6.92M against the annual target line of $1.34M.
Tax treatment flag: capital roof replacement/improvement — CPA review for Section 179 aggregate limit, MACRS depreciation, and possible 179D.
Step 3 · live consequence panel
Selected year cash deployment
$6.92M
Capital + maintenance + deferral-control expense in 2026
Win / loss against target
LOSS
Above target by $5.57M
Portfolio deferred liability
$0
Capital vs. expense
Capital equals replacement and improvement scope. Expense equals maintenance and repair scope. Every tax result remains a CPA-review item, not tax advice.
IR-informed capital timing
Wet-insulation takeoff ledger
NIRA public viewer evidence is converted into editable wet-area placeholders and decay modifiers. Roofs 1 and 6 are completed assets, so they are shown as stabilized rather than active wet-insulation priorities.
12,767
Est. active wet SF
48
Anomalies
2
High/Critical
IR overview image placeholder
Drop NIRA overview scan here
Reserved for a portfolio-wide thermal/NIRA overview image. Once supplied, it can replace this card and align the wet-area ledger with the actual scan page.
| Roof | IR tier | Wet SF | Decay impact | Owner interpretation |
|---|---|---|---|---|
| Roof 1Upper Walker / Bldg 200 | Post-Replacement | 0 (0.00%) | 1.00x | Stabilized replacement asset; track warranty rather than re-prioritize. |
| Roof 2Lower Walker | None | 0 (0.00%) | 0.95x | Preserve asset value through monitoring and low-cost maintenance. |
| Roof 3Duro-Last Section | Moderate | 571 (1.50%) | 1.15x | Moisture remains limited, but aging can still erode restoration value if delayed. |
| Roof 4EcoLab Main | Severe | 5,232 (3.00%) | 1.35x | Moisture is material enough to change timing economics and scope confidence. |
| Roof 5EcoLab 2 | Trace | 1,260 (0.75%) | 1.05x | Moisture remains limited, but aging can still erode restoration value if delayed. |
| Roof 6Nalco / Roof Area 6 | Post-Replacement | 1,161 (0.78%) | 1.00x | Stabilized replacement asset; track warranty rather than re-prioritize. |
| Roof 7Nalco / Roof Area 7 | Trace | 933 (0.80%) | 1.07x | Moisture remains limited, but aging can still erode restoration value if delayed. |
| Roof 8Ballast EPDM & TPO | Significant | 3,916 (2.25%) | 1.25x | Moisture is material enough to change timing economics and scope confidence. |
| Roof 9Wake Forest / BUR | Moderate | 855 (1.25%) | 1.12x | Moisture remains limited, but aging can still erode restoration value if delayed. |
Roof asset register
Prioritized investment table
Select a roof to inspect strategy cost, window status, risk reasoning, and source-model notes.
| Roof | SF | Risk | IR Moisture | Recommended | Selected Action | Year | Spend | Window | Detail | ||
|---|---|---|---|---|---|---|---|---|---|---|---|
| 140,085 | Low | Post-Replacement1.00x decay | Completed100/100 · Do not re-budget | Completed | Completed | $0 | $9K$0 3-year defer | Protected | Report | ||
| 18,190 | Low | None0.95x decay | Repair43/100 · Stage / validate | Monitor | $0 | $13K$25 3-year defer | Open | Report | |||
| 38,098 | Medium | Moderate1.15x decay | Retrofit100/100 · Spend now | Replace / Claim Validate | $476K | $3K$317K 3-year defer | At Risk | Report | |||
| 174,400 | High | Severe1.35x decay | Retrofit100/100 · Spend now | Retrofit / Replace before deck escalation | $1.37M | $4K$1.48M 3-year defer | Lost | Report | |||
| 168,000 | Medium | Trace1.05x decay | Repair96/100 · Spend now | Restore | $924K | $4K$416K 3-year defer | Open | Report | |||
| 148,730 | Low | Post-Replacement1.00x decay | Completed100/100 · Do not re-budget | Completed | Completed | $0 | $9K$0 3-year defer | Protected | Report | ||
| 116,595 | Medium | Trace1.07x decay | Repair96/100 · Spend now | Restore | $641K | $3K$275K 3-year defer | Open | Report | |||
| 174,040 | High | Significant1.25x decay | Repair91/100 · Spend now | Maintain / Defer until rentability shift | $2.18M | $4K$42K 3-year defer | Lost | Report | |||
| 68,361 | Medium | Moderate1.12x decay | Repair91/100 · Spend now | Restore | $376K | $3K$184K 3-year defer | Open | Report |
Capital and expense budget forecast
Year-by-year capital versus operating expense
This budget view separates one-time capital decisions from recurring annual monitor/maintenance expense and short-term deferral cost, so the owner can distinguish planned CapEx from operating drag.

Capital route
Immediate, short-term, and long-term planning
Capital sequencing is grouped into decision windows so the owner can see whether spend is being deployed before restoration windows close.
Immediate
$5.96M
Annual Maintenance
$51K
Short-Term Deferral Cost
$2.71M
Long Term
$0
Model logic
Decision rules embedded
Risk score: combines physical condition, moisture/deck exposure, criticality, and likelihood of unexpected liability.
Escalation: future actions are priced with the active inflation assumption, currently 5.0% annually.
Deferral: deferred roofs carry deterioration and emergency premium logic, emphasizing true lifecycle cost rather than first-cost optics.
Asset-management question: the dashboard tests what happens if ownership spends a little now, waits, and spends later instead of only pricing today’s roof work.
Selected roof profile
Roof 4: EcoLab Main
Second-worst original asset; leaks align with IR anomalies. section4.pdf provides Roof 4 plot context while the 6-4-2025 leak catalog explains the decay driver: cold-torched APP patchwork trapping moisture, vapor-cycling the BUR felts, open laps, missing flashings, and submerged tie-ins. Ignore the incorrect top-left photo in section4.pdf per owner correction.
System
Original BUR with SBS modified patch areas
Condition
50/100
Accelerated / Patchwork-Driven Failure Phase
Recommendation
Partial but strong evidence: Roof 4 has 0-1 year restoration/retrofit viability; deferral can force full deck replacement because failed patchwork and active leaks accelerate decking decay.
IR / moisture timing signal
Highest active wet-insulation priority. section4.pdf adds usable plan/detail callouts and scope caveats; the 6-4-2025 leak catalog ties accelerated decay to failed cold-torched APP patchwork, trapped moisture, vapor cycling, open laps, missing flashings, and submerged tie-ins. The user-identified incorrect top-left photo remains excluded from interpretation.
5,232 SF estimated wet · Severe · 1.35x decay modifier
Base capital
$1.37M
One-time option before escalation
Annual maintenance
$4K
Recurring monitor/maintain cost
Short-term deferral
$1.48M
Modeled 3-year cost of waiting
AI cash score
100/100
Spend now
Action comparison
True cost menu
Planning note
Restoration window is likely lost; validate scope before assuming lower-cost options remain viable.
